The project is meticulously and methodically designed, with outstanding features such as construction of synchronous equipment in terms of facilities and technical infrastructure; To create a favorable working environment for domestic and foreign enterprises to set up working offices; The scale and form of the building contributes to the beauty of the area's architectural landscape, making it the highlight of the main road to the city center.
As one of the four Grade-A buildings directly executed by Sigma Engineering as the Main M&E Contractor, Doji Commercial and General Services Complex is designed to be divided into three blocks: the commercial center (basement ~ 5th floor), office block (6th ~ 9th floor), office block for rent (10th ~ 16th floor) is plated gold. With professional style and deep experience, Sigma has started to deploy the M&E works of the project since November 2017, received absolute trust from the investor. Sigma's manpower now is stable, with nearly 50 employees and 12 engineers diligently taking Doji to the right track based on the schedule.
Last week, from April 7 - April 12, 2018, the main M&E works are being deployed at the project such as cable tray, conduit, duct and pipe installation (water supply and water drainage pipes, fire-fighting pipe, copper pipe, condensate pipe). The quantity of performed works as follows:
- Trade center block (basement ~ 5th floor): 30% cable tray, conduit, duct and pipe installation
- Office block (6th ~ 8th floor): Carrying out cable ladder work
- Offices for rent (10th ~ 15th floor): 80% of pipes
Some pictures of the project last week:

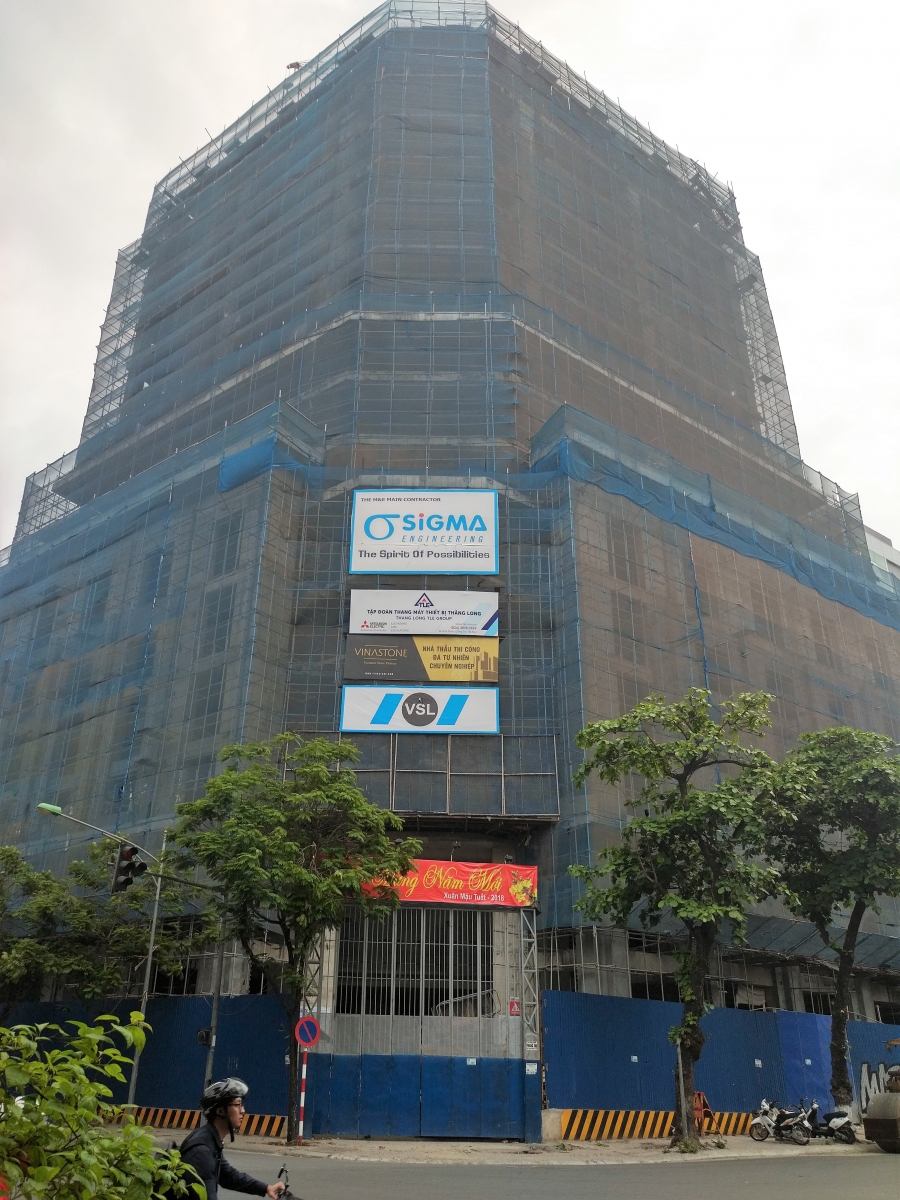

Overview of the Doji project

Storage area at the project is arranged clean, tidy

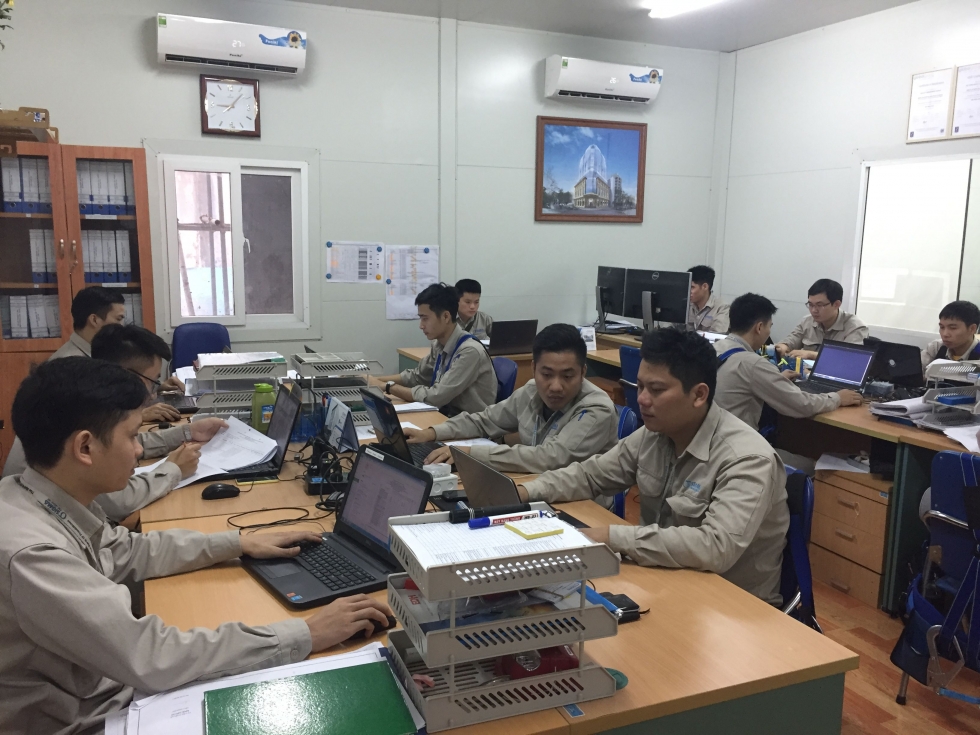

Working atmosphere at the office

Periodical safety inspection of installation machines

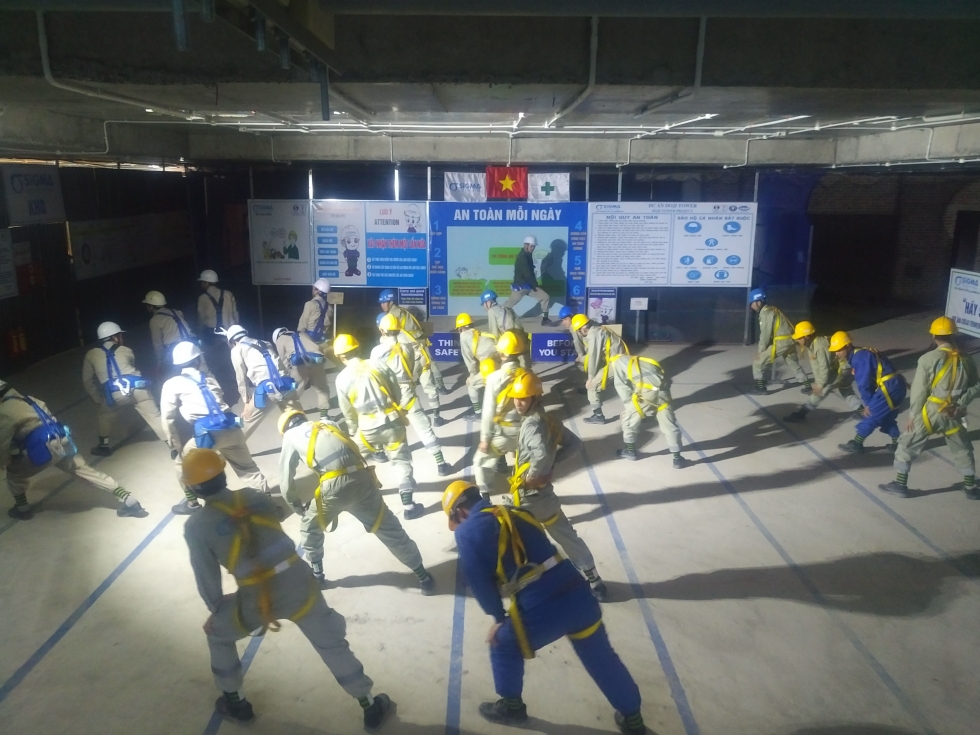

Tool Box Meeting daily at the project

Installation of conduit on the 10th floor

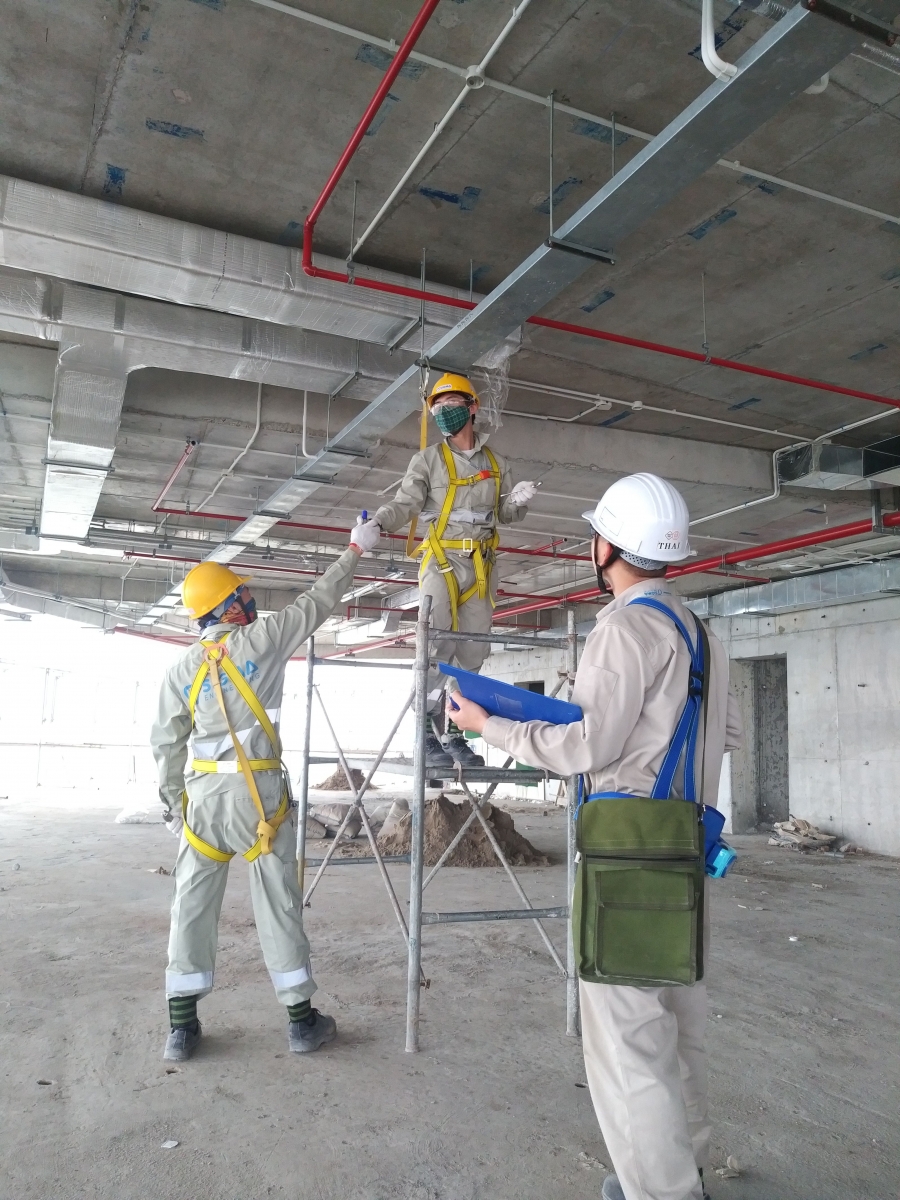

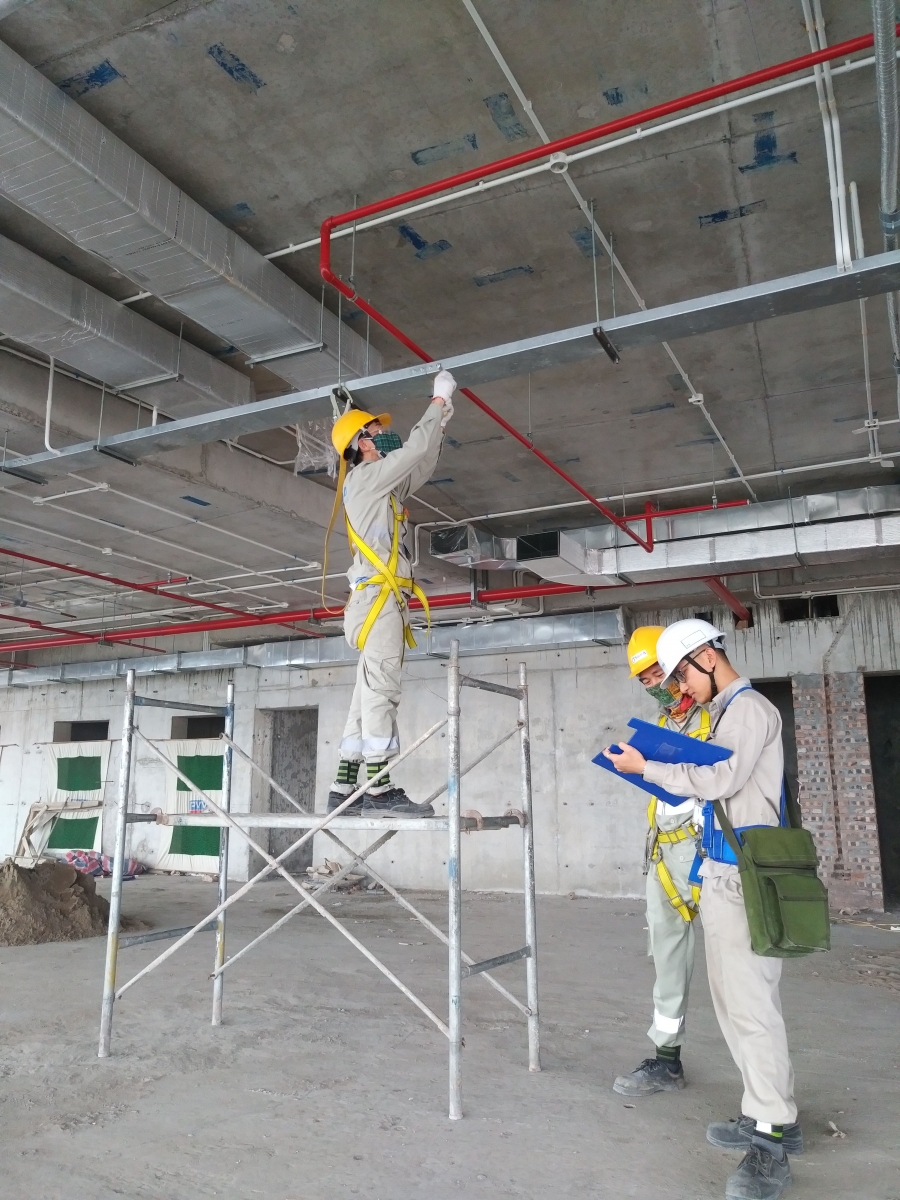

Installation of cable tray on the 11th floor
